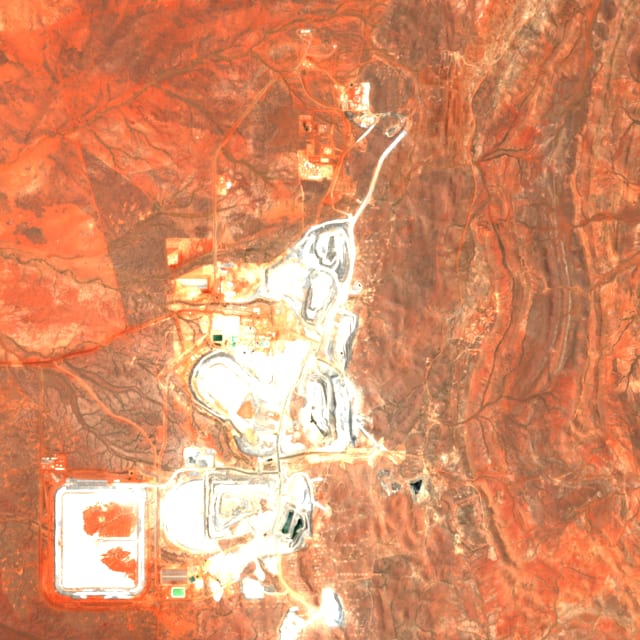

Mine / resource · Australia

Pilgangoora

ProducingVerified 24 Oct 2026As of 24 Oct 2026
Owner
PLS Group 100%
Listed via
PLS.AX
Product
Spodumene
Deposit type
Spodumene
Capacity
FY26 879.5 kt SC; FY27 guidance 1,030–1,100 kt SC
≈ 125 kt LCE/yr (guidance)
Location
-21.05°, 118.91°
Source
Filing used for verification

P2000 FID approved 16 Oct 2026: new Jimmagunya plant to lift production to ~2.0 Mtpa SC.

Ownership structure

Effective economic interest of listed owners · As of 23 Oct 2026
PLS GroupPLS.AX100%PilgangooraMine / resource

Attributable capacity

Listed ownerStakekt SC/yrkt LCE/yr
PLS Group PLS.AX100%≈1,003≈125

Capacity × effective stake. kt SC ≈ kt LCE × 8.0 (grade-based, 90% recovery).

Structure: PLS Group 100%.

Value chain

Owners, buyers and the refineries on Li3atlas they feed · As of 24 Oct 2026
Mine / resourcePilgangooraFY26 879.5 kt SC; FY27 guidance 1,030–1,100 kt SC

Quarterly production

As of 30 Jun 2026
0100200300UnverifiedJun Q 2025: 221 kt SC221AUD 619Sep Q 2025: 225 kt SC225AUD 540Dec Q 2025: 208 kt SC208AUD 585Mar Q 2026: 232 kt SC232AUD 520Jun Q 2026: 214 kt SC214Q2 25Q3 25Q4 25Q1 26Q2 26Q3 26Cost/t

kt SC, as reported · Source: Mar Q 2025, Jun Q 2025, Sep Q 2025, Dec Q 2025, Mar Q 2026, Jun Q 2026

232$2,415Production (kt SC): 125Sales (kt SC): 125.5Mar Q 25Production (kt SC): 221.3Sales (kt SC): 216Jun Q 25Production (kt SC): 224.8Sales (kt SC): 214Sep Q 25Production (kt SC): 208Sales (kt SC): 232Dec Q 25Production (kt SC): 232.4Sales (kt SC): 195.7Mar Q 26Production (kt SC): 214.3Jun Q 26
Production (kt SC)Sales (kt SC)Realised price (US$/t) (US$, right axis)Unit cost (≈ US$)
Jun Q 26Mar Q 26Dec Q 25Sep Q 25Jun Q 25Mar Q 25
Production (kt SC)214.3232.4208224.8221.3125
Sales (kt SC)—195.7232214216125.5
Implied inventory change (prod − sales)—+36.7−24+10.8+5.3−0.5
Unit cost (AUD/t)—520 ≈$338585 ≈$380540 ≈$351619 ≈$402685 ≈$445
Realised price (US$/t)$2,415$2,155$1,336$841$703$851
Implied cash margin (US$/t)—+$1,817 84%+$956 72%+$490 58%+$301 43%+$406 48%

Production minus sales in the same unit: positive = stockpile built at the mine or port, negative = drawn down. Margin = realised price − unit cost converted at fixed FX. Bases can differ (price often CIF and SC6-equivalent, cost FOB per t of the actual grade, before royalties), so treat it as indicative.

Resource and mine life

As of 24 Oct 2026
Resource
13.24 Mt LCE
Reserve
7.63 Mt LCE
Grade
1.33% Li2O
Mine life
20 years
As of
30 Jun 2026

Unit cost

Basis
FOB per t concentrate (guidance A$575–625)
Period
FY27 guidance

Cost bridge to US$/t LCE

Reported unit cost
AUD 600/t SC
In US$ (fixed FX)
× 0.65 = $390/t SC
× t concentrate per t LCE
× 8.02 (5.6% Li₂O, 90% recovery)
Mine cost per t LCE
$3,129/t LCE
+ Conversion to chemicals (assumption)
$3,500 · China Merchant Toll
+ Royalty (WA 5% of realised price)
$701 (5% × SC6 $1,873/t, latest average realised)
Landed cost
$7,330/t LCE
Cost-curve quartile Q3 of 14 operations with a cost

Reported cash costs exclude the 5% WA royalty; it is modelled separately here. The conversion, freight and royalty settings are shared with the cost curve on the map page (Economics).

Position on the cost curve

Landed US$/t LCE, same assumptions as the cost curve · As of 24 Oct 2026
Hombre Muerto West (HMW): $3,963/t LCEQarhan Salt Lake: $4,292/t LCE (implied)Cauchari-Olaroz: $5,897/t LCEYichun lepidolite belt: $6,012/t LCE (implied)Greenbushes: $6,201/t LCEPilgangoora: $7,330/t LCEPilgangooraMibra: $7,416/t LCEWodgina: $7,489/t LCEFinniss: $7,913/t LCEZabuye Salt Lake: $8,265/t LCE (implied)Mt Marion: $9,166/t LCEGrota do Cirilo: $9,503/t LCEKathleen Valley: $10,203/t LCENorth American Lithium: $11,166/t LCE$11,1660

$7,330/t LCE · cheaper than about 40% of costed supply

Grey: every producing mine with a cost (width = capacity). Highlighted: this asset. Lighter dashed bars are implied costs (no reported unit cost).

Milestones

As of 24 Oct 2026

Upcoming (2)

  • 28 Oct 2026September 2026 Quarterly Activities ReportReport · source
  • Q3 2029P2000 (Jimmagunya plant) first productionFirst production · source

Completed (8)

  • 21 Oct 2026US$700M 8.00% Senior Unsecured Notes due 2032 pricedFinancing · source
  • 16 Oct 2026P2000 final investment decision (~2.0 Mtpa)FID · source
  • 1 Jul 2026Ngungaju plant restartRestart · source
  • 19 Jun 2026P2000 pre-FID capex (~A$175M) approvedOther · source
  • 23 Apr 2026US$600M 6.875% Senior Notes due 2031 closedFinancing · source
  • 19 Feb 2026Board approves Ngungaju plant restart (~200 ktpa)Restart · source
  • 10 Feb 2026Canmax offtake executed (150 ktpa, 2 years, US$100M prepayment)Offtake · source
  • 31 Jan 2025P1000 Pilgan plant expansion first oreExpansion · source

Country risk · Australia

Policy risk: Low As of 24 Oct 2026
Royalty
Western Australia: 5% of gross sales revenue on spodumene concentrate, at first point of sale (since 28 Mar 2020)

Stable fiscal regime; royalty set by the state. source

Change history

Approved changes with their source · As of 24 Oct 2026
DateFieldChangeSource
24 Oct 2026Milestonenew: 23 Apr 2026 · US$600M 6.875% Senior Notes due 2031 closed Financing CompletedPLS completes US$600 million Senior Unsecured Notes Offering (23 April 2026)
24 Oct 2026Realised pricenew: Spodumene US$703/t · Jun Q 2025 · SC6 equiv., CIF ChinaPLS June Quarterly Activities Report (30 July 2025)
24 Oct 2026Quarterly figuresnew: Sep Q 2025 · production 224.8 kt SC · sales 214 kt SC · cost AUD 540 (FOB Port Hedland per t SC (excl. freight and royalties))PLS September Quarterly Activities Report (24 October 2025)
24 Oct 2026Realised pricenew: Spodumene US$841/t · Sep Q 2025 · SC6 equiv., CIF ChinaPLS September Quarterly Activities Report (24 October 2025)
24 Oct 2026Milestonenew: 10 Feb 2026 · Canmax offtake executed (150 ktpa, 2 years, US$100M prepayment) Offtake CompletedPLS executes offtake agreement with Canmax (10 February 2026)
24 Oct 2026Quarterly figuresnew: Dec Q 2025 · production 208 kt SC · sales 232 kt SC · cost AUD 585 (FOB Port Hedland per t SC (excl. freight and royalties))PLS December Quarterly Activities Report (30 January 2026)
24 Oct 2026Realised pricenew: Spodumene US$1,336/t · Dec Q 2025 · SC6 equiv., CIF ChinaPLS December Quarterly Activities Report (30 January 2026)
24 Oct 2026Milestonenew: 19 Feb 2026 · Board approves Ngungaju plant restart (~200 ktpa) Restart CompletedNgungaju plant restart and growth studies update (19 February 2026)
